Weather Sunny & Windy 83˚/50˚
Subs on Site
<Red Oak> (6)
<DG Concrete> (3)
Work in Progress:

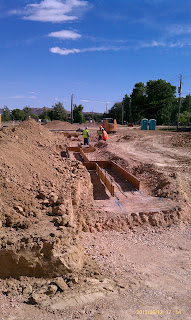

(Red Oak) expanded the footing on the north end of the building as per the foundation correction received today in RFI # 3. (Red Oak) also formed the first of the four spot footings at 6'x6' as per RFI #4
(DG Concrete) re-dug and installed structural fill for the footings for the patio walls while they dug the spot footing pad for the columns at each end of the breezeway. (DG Concrete) also installed the fire riser for Building 'A' as well as finishing the water laterals on Building 'C'&'B'.
(DG Concrete) charged and started the chlorine bake of the water main.
