Friday 9/28/2012


Weather: Sunny 71˚/41˚

Subs on Site
<Utek>                         (10)
<DG Concrete>            (2)

Work in Progress:
(Utek) Started pick-up of the 1st level and continued framing the South end of the 4th floor.

(DG Concrete) Worked on the road from between Building 'B' & 'E' to

Thursday 9/27/2012


Weather: Cloudy 66˚/44˚

Subs on Site
<Utek>                         (10)
<DG Concrete>            (2)

Work in Progress:
(Utek) Started pick-up of the 1st level and continued framing the South end of the 4th floor. They also built the tapered columns on the exterior.

(DG Concrete)Had E-fill and Road base delivered and started down the road with E-fill from 2500 W to between Building 'B' and 'D' they will stay tomorrow to help get closer to Asphalt readiness

Wednesday 9/26/2012


Weather: Rain 64˚/35˚

Subs on Site
<Clegg Steel>               (3)
<Utek>                         (11)
<Red Oak>                   (7)
<DG Concrete>            (2)

Work in Progress:
It Rained all day.  The framers fork lift got stuck up to its axles.  Clegg Steel got shocked while trying to weld and the equipment tore up our E-fill in the parking lot and road.

(Clegg Steel) Installed stairs for the South West corner of Building 'A'

(Utek)Worked with Clegg Steel with their crane to set the stairs. And worked on interior walls and pick up for the 2nd Floor.

(DG Concrete) back filled on one corner of Building 'B' and cleaned up the track out on 2500 W over and over.

Tuesday 9/25/2012

Weather: Rain 73˚/48˚

Subs on Site
<Utek>                         (11)
<Red Oak>                   (7)
<DG Concrete>            (2)

Work in Progress:
(Utek)Framed walls on the 4th floor 65% complete. Worked with Clegg Steel with their crane to set the stairs. And worked on interior walls and pick up for the 2nd Floor.

(Red Oak) Tied bar for the Club House and passed inspection


(DG Concrete) finished the parking lot for Building 'A'

Monday 9/24/2012

Weather: Partly Cloudy  73˚/48˚

Subs on Site
<Clegg Steel>               (3)
<Utek>                         (11)
<Red Oak>                   (7)
<DG Concrete>            (2)

Work in Progress:
(Clegg Steel) Installed stairs for the South West corner of Building 'A'

(Utek)Framed walls on the 4th floor 50% complete. Worked with Clegg Steel with their crane to set the stairs. And worked on interior walls and pick up for the 2nd Floor.

(DG Concrete) graveled the Club House and wet the E-fill material to get it ready to install in the road. Shad had to run to Indian Canyon with the mini because Brad was over weight with the rocks for the rock walls.

Friday 9/21/2012


Weather: Sunny  81˚/43˚

Subs on Site
<Utek>                         (11)
<Red Oak Plumbing>    (5)
<Red Oak>                   (7)

Work in Progress:
(Utek) delivered a tower crane with a man basket.  Continued 4th floor Building 'A' walls. Built interiors on 3rd floor as well as completing the clean up of all brackets and bracing.

(Red Oak Plumbing) back filled Building 'B' underground.  We discovered that Ether had missed the Type 'A' unit so they dug it back up and changed the layout on that unit.

(Red Oak) Poured the breeze way and patios on Building 'E'.

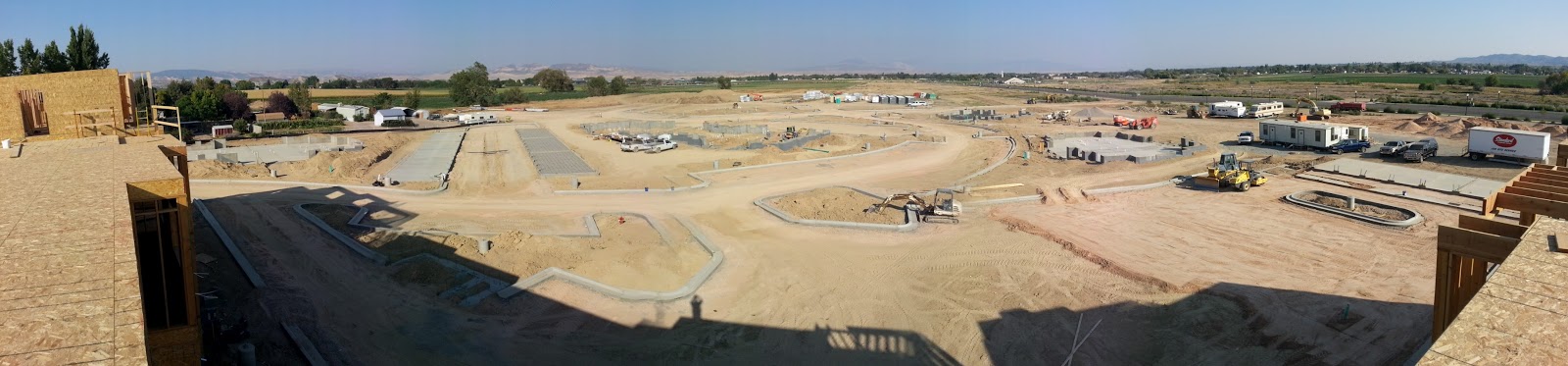

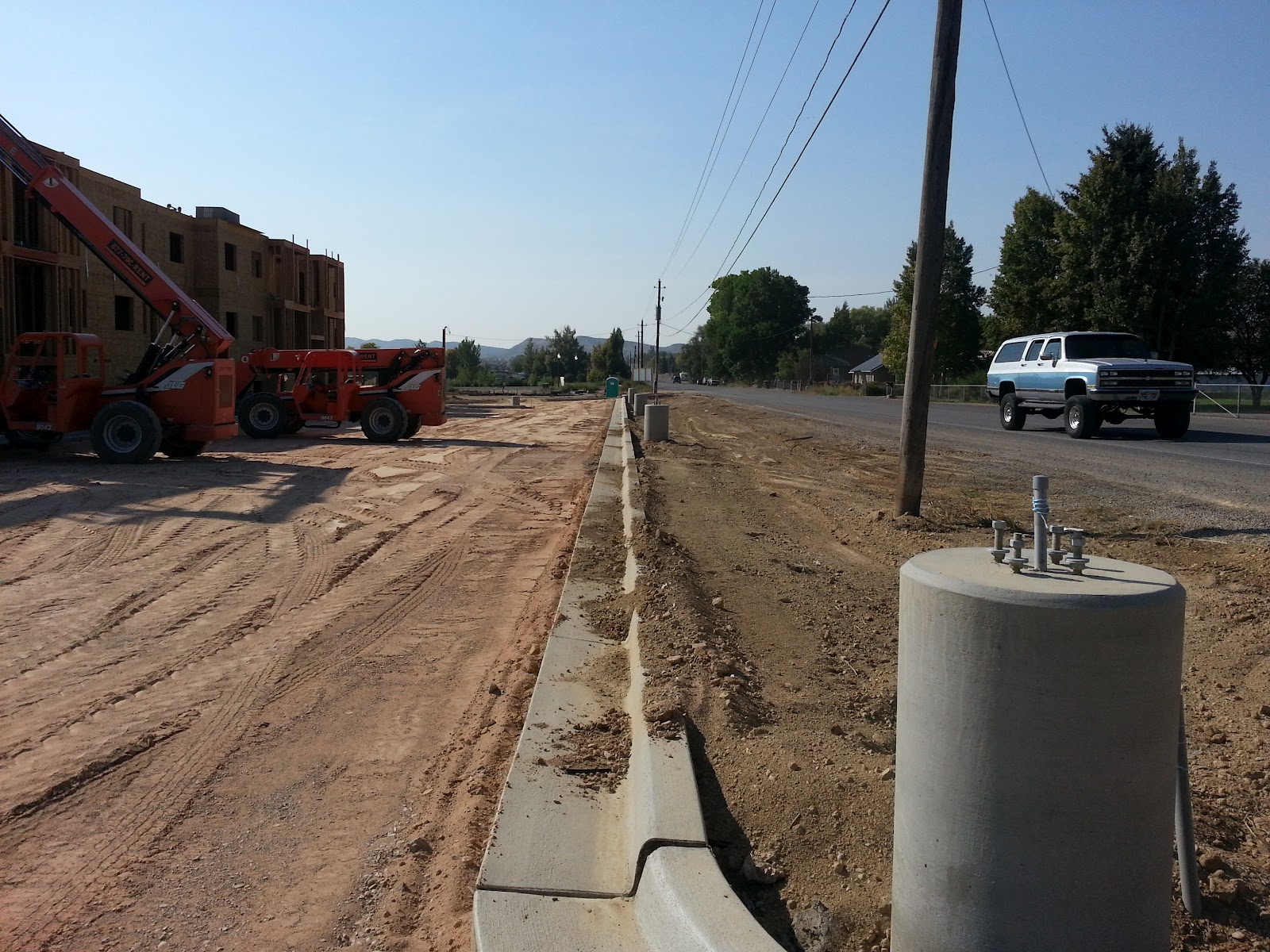

Thursday 9/20/2012


Weather: Sunny  77˚/47˚

Subs on Site
<Utek>                         (11)
<Red Oak Plumbing>    (5)
<Red Oak>                   (7)
<DG Concrete>            (2)

Work in Progress:
(Utek) delivered a second fork lift and a man basket.  Then started 4th floor Building 'A' walls. The also installed the 4th floor landings

(Red Oak Plumbing) passed inspection for underground in Building 'B' and started backfill

(Red Oak)Poured Building 'E' floor

(DG Concrete) started installing E-fill in East end of  Building 'A' parking lot.  Compaction Test passed on the South end.

For Nick

Wednesday 9/19/2012


Weather: Partly Cloudy  77˚/46˚

Subs on Site
<Utek>                         (8)
<Reliance>                    (3)
<Red Oak Plumbing>    (4)
<Red Oak>                   (7)
<DG Concrete>            (2)

Work in Progress:
(Utek) delivered their tractor trailer with a forklift, large saw and prefab equipment.  Then started Building 'A' clean up.

(Reliance)laid the conduit for Strata along 2500 W and backfilled the trench.  Installed the fire alarm loop in Building 'B' then loaded their equipment and left for Farmington.

(Red Oak Plumbing) installed underground in Building 'B'

(Red Oak) tied bar in Building 'B' garage floor.

(DG Concrete) started installing E-fill in West end of   Building 'A' parking lot.  Compaction Tests failed in Building 'C' parking lot. Too Dry.


Tuesday 9/18/2012


Weather: Partly Cloudy  77˚/45˚

Subs on Site
<Reliance>                    (3)
<Red Oak Plumbing>    (4)
<DG Concrete>            (2)

Work in Progress:
(Utek) delivered their work trailer and office equipment

(Reliance)Trenched for Strata along 2500 W

(Red Oak Plumbing) trenched for Building 'B' underground plumbing. Backfilled the Club House

(DG Concrete) Backfilled the 2nd half of Building 'B' floor and started installing E-fill in Building 'C' parking lot

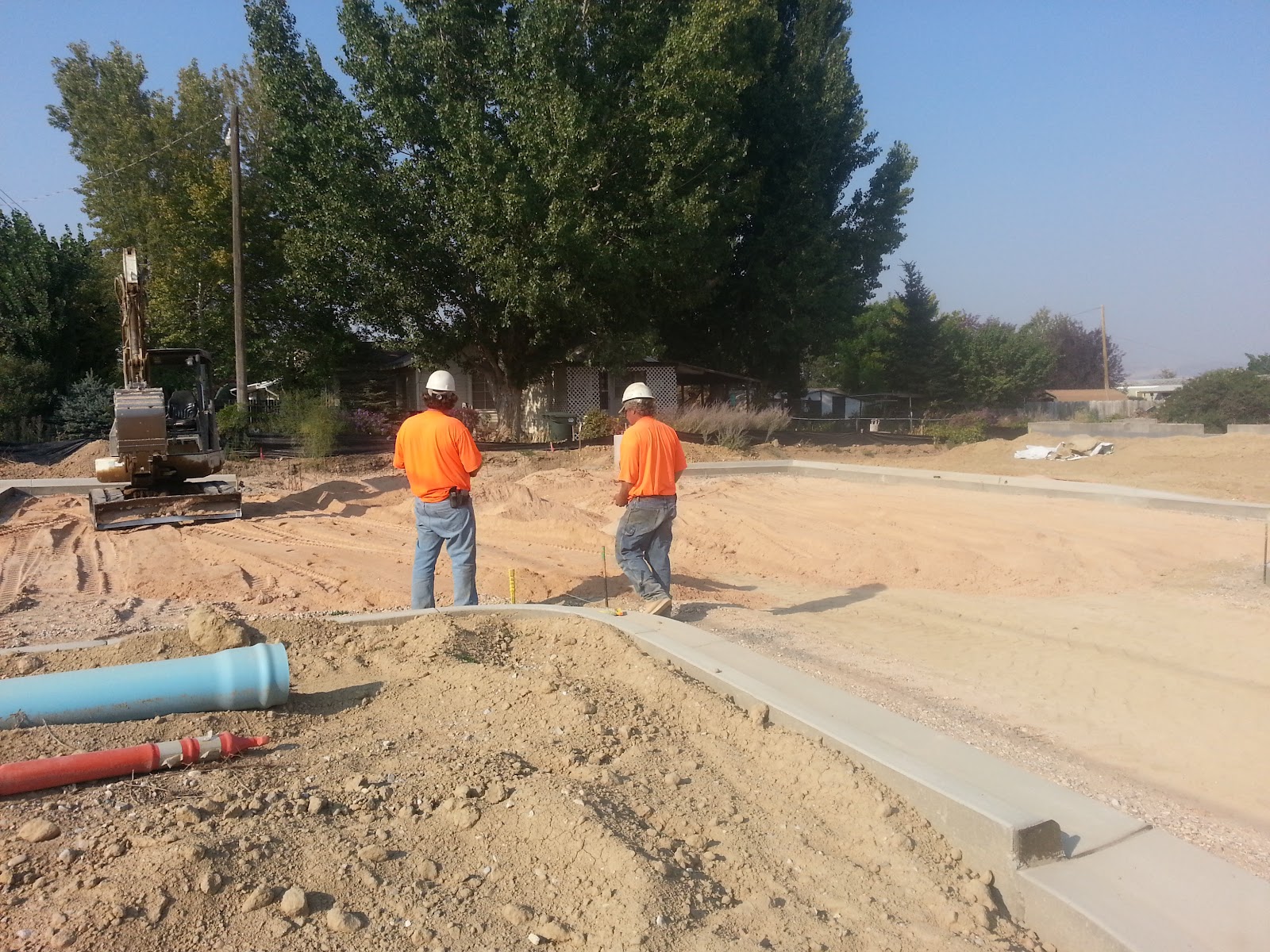

Shad (DG Concrete) hit electrical conduit



Monday 9/17/2012



Weather: Partly Cloudy  74˚/44˚

Subs on Site
<Red Oak Plumbing>    (3)
<Red Oak>                  (6)
<DG Concrete>            (2)

Work in Progress:
(Red Oak Plumbing) Club House underground plumbing

(Red Oak) Tied the bar for Building 'E' floor.

(DG Concrete) Backfilled the floor on Building 'B'.  Shad had to run to Ballard to get a compactor.

(Clegg Steel) delivered the stair sections for Building 'A'.  I unloaded them.

Thursday 9/13/2012


Weather: Partly Cloudy  78˚/47˚

Subs on Site
<Red Oak>                  (8)
<DG Concrete>            (2)

Work in Progress:
(Red Oak) Poured Building 'B' breezeway foundation walls

(DG Concrete) Dug the water way between 'B' & 'C' garages

Wednesday 9/12/2012


Weather: Partly Cloudy  78˚/50˚

Subs on Site
<Reliance>                   (1)
<DG Concrete>            (2)

Work in Progress:
(Reliance)had a dumpster delivered

(DG Concrete)sub graded for the turn around.

Tuesday 9/11/2012


Weather: Partly Cloudy  74˚/49˚

Subs on Site
<Sterns>                      (10)
<Reliance>                   (1)
<Red Oak>                  (6)
<DG Concrete>            (2)

Work in Progress:
(Sterns) formed and poured the dumpster pads

(Reliance)ran conduit into Club house before back fill

(Red Oak)Formed Building 'B' breezeway Foundation and passed inspections

(DG Concrete)back filling Club house floor touched up the dumpster footings and the parking sub base

I met with Paul (Utek) after they went over the material on site.  We discussed the trusses and where they will be putting the crane for each building.

Monday 9/10/2012


Weather: Partly Cloudy  85˚/57˚

Subs on Site
<Reliance>                   (3)
<Red Oak>                  (4)
<DG Concrete>            (2)

Work in Progress:
 (Reliance) pulled Primary to Building 'B' and Club House foundations and set a temp power panel for 'D' and dug trenches for Club house

(Red Oak)Formed Building 'B' breezeway Foundation

(DG Concrete)  back filling Building 'B' garage floor and added gravel


Friday 9/7/2012


Weather: Partly Cloudy  80˚/52˚

Subs on Site
<Reliance>                   (3)
<Red Oak>                  (10)

Work in Progress:
(Reliance)pulled temp power to Building 'D' & 'E'

(Red Oak)Poured the southern 2/2 walls on Building 'B' then missed inspection on the Club House walls. I called and rescheduled for later.  They passed inspection and poured the Club House walls.

Thursday 9/6/2012


Weather: Partly Cloudy  83˚/49˚

Subs on Site
<Reliance>                   (3)
<Red Oak>                  (10)
<DG Concrete>            (2)

Work in Progress:
 (Reliance) Vacuumed pull cord through their conduit.  Trenched from the light pole by the Playground to Building 'E' and repaired the conduit near the Club House.

(Red Oak)Formed 2/2 Building 'B' Foundation and passed inspection.

(DG Concrete) dug the foundations for the Dumpster pads and started back filling Building 'B' garage floor.

Wednesday 9/5/2012


Weather: Clear  85˚/54˚

Subs on Site
<Reliance>                   (3)
<Red Oak>                  (8)
<DG Concrete>            (2)

Work in Progress:
(Reliance) set transformer pads around Building 'D' & 'E' and moved the sectionalizer out of the sidewalk by Building 'C'

(Red Oak) Poured 1/2 Building 'B' Foundation and the Club House footing

(DG Concrete) graveled 2/2 Building 'E' floor, fixed their mini's boom, and installed the road crossing for the landscaper.





Tuesday 9/4/2012


Weather: Clear  82˚/49˚

Subs on Site
<Sterns>                      (7)
<Reliance>                   (3)
<Red Oak>                  (8)
<DG Concrete>            (2)

Work in Progress:

(Sterns) poured the tie ins around the sections of curb they slipped Friday

(Reliance) set transformer pads around Building 'A' & 'C'

(Red Oak) Poured the Garage floor for Building 'C' and finished forming the Foundation wall for Building 'B' and started on the Club House footing

(DG Concrete) graveled 1/2 Building 'E' floor.







Friday 8/31/2012


Weather: Partly Cloudy  84˚/58˚

Subs on Site
<Sterns>                      (4)
<Red Oak>                  (6)
<Horrocks>                  (1)

Work in Progress:
(Sterns)Slipped the last sections of curb

(Red Oak) poured the footings for Building 'B' and the foundation walls on Building 'B' Garage.  I ran to Burton Lumber Lindon to pick up the straps for Building 'B' Garage walls and the Club House, then met Charlie (Red Oak) at Fruitland and he took them back.
