Subs on Site
<Huskies> (3)
<Green Clean> (2)
<G&M Woods> (2)
<G&M Woods> (2)
<Wall to Wall> (1)
<Diamond Z> (3)
<Clegg Steel> (5)
<Clegg Steel> (5)
<Air Doctors> (3)
<Reliance> (4)
<DG Concrete> (3)

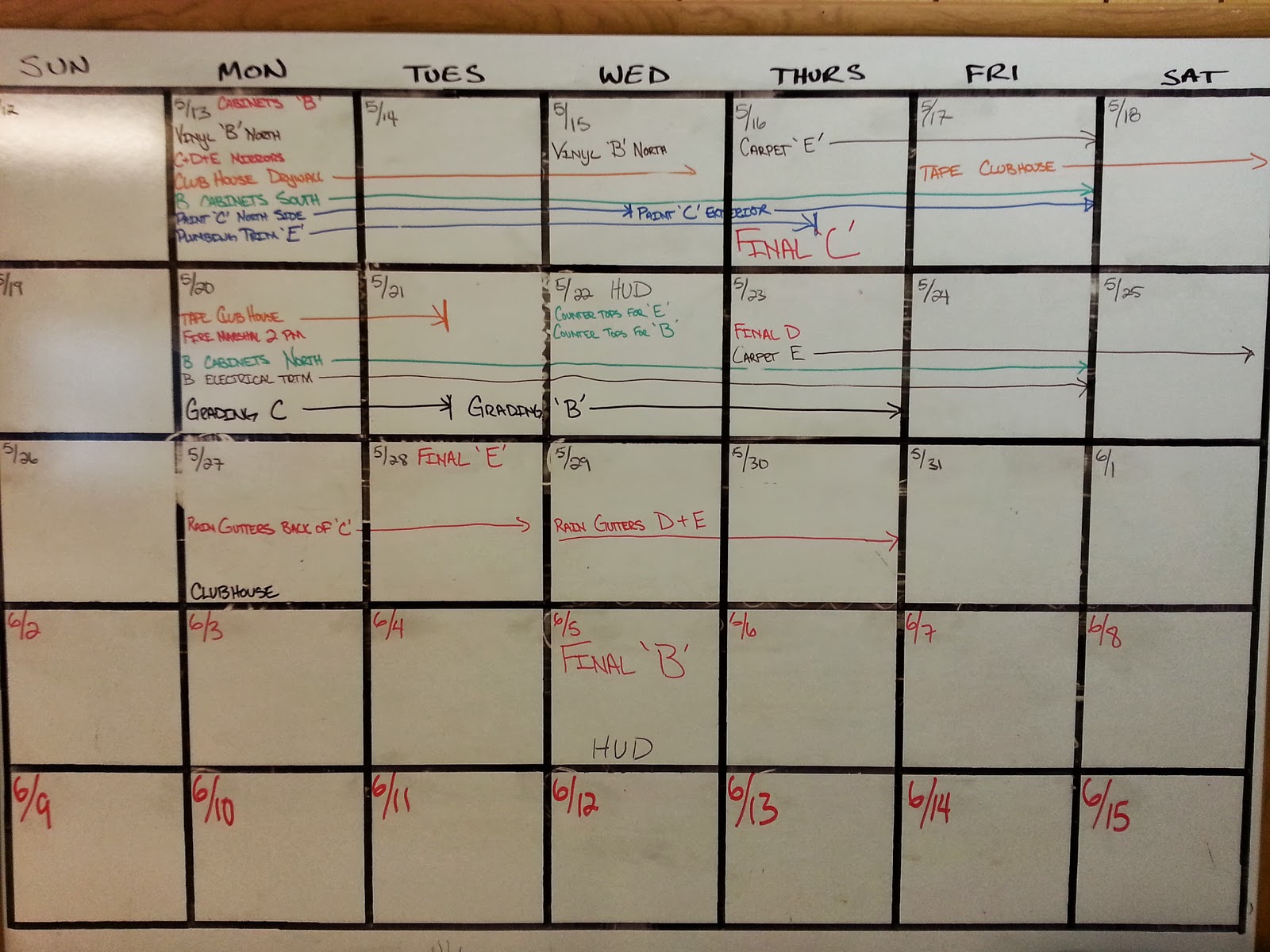

Work in Progress
(Huskies) Trenching and final grade around Building 'E'.
(G&M) Finished counter tops on North tower of Building 'B'. I called Melissa (SACO) and they are going to send a new above stove cabinet.
(Wall to Wall) Prepped the breeze ways of Building 'D'.
(Diamond Z) Caulked the column caps were they met with the steel.
(Clegg Steel) fixed the stairs in Building 'E', installed hand rails for the stairs in Building 'B', cut down chimney caps, installed the sheets to cover the stair landings.
(Reliance) Worked on the trim in the North tower of Building 'B' and items from Building 'E' final inspection.
(DG Concrete) Graded the west side of Building 'B' for rock walls and the break for drainage.
We had final re inspection on Building 'D'. We pass for all but the exterior items and 2 notes for the plumber. Aaron also asked that we install ramps at the end of the walks in the sections were we could not pour for safety.
