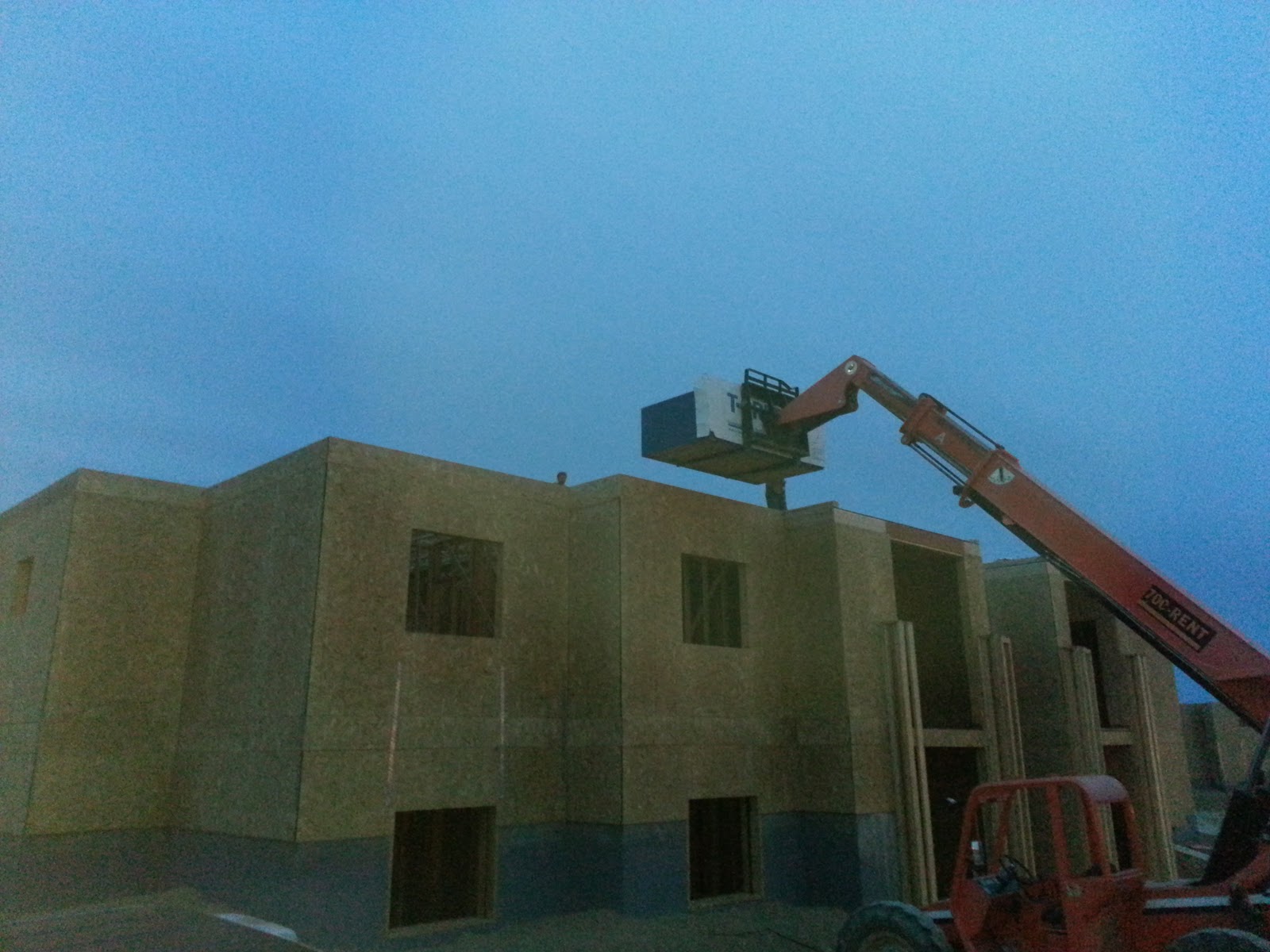

Thursday 11/29/2012

Weather: Sunny 47˚/25˚

Subs on Site
<Cardalls>                      (2)
<Warburtons>                (11)
<Nutek>                          (3)
<Diamond Z>                  (4)
<Extreme Fire>               (5)
<Air Doctors>                 (4)
<Utek>                           (19)
<Red Oak Plumbing>     (5)

Work in Progress:
(Cardalls)Insulated the walls on the 2nd Floor for Building 'A'.

(Warburtons) siding on both sides of the center section of Building 'A' as well as Building 'A' garage.

(Nutek) pre-rock on the 2nd floor of Building 'A'

(Diamond Z) stoned the North end of Building 'A' and the North Entry Columns.

(Extreme Fire) worked on the attic system of Building 'A'.  Worked on the 2nd floor of Building 'C'

(Air Doctors)installed the vents for the remainder of Building 'A'

(Utek)worked on Building 'C' roof.  Framed the 1st floor of Building 'B'. Sheeted the 3rd floor on Building 'D'



(Red Oak)Finished out and passed inspection on the South end of 3rd and 4th floors of Building 'A' and finished the ADA tubs.

Wednesday 11/28/2012

Weather: Sunny 49˚/24˚

Subs on Site
<Cardalls>                      (2)
<Warburtons>                (12)
<Nutek>                          (3)
<Diamond Z>                  (3)
<Extreme Fire>               (4)
<Air Doctors>                 (4)
<Utek>                           (19)
<Red Oak Plumbing>     (5)

Work in Progress:
(Cardalls)Insulated the walls on the 2nd Floor for Building 'A'.

(Warburtons) started siding on both sides of the center section of Building 'A' as well as Building 'A' garage.

(Nutek) started pre-rock on the 2nd floor of Building 'A'

(Diamond Z) stoned the North end of Building 'A'.

(Extreme Fire) worked on the attic system of Building 'A'

(Air Doctors) drilled holes in the hard duct for 1st floor of Building 'A' .  They also strapped the vents in the attic.

(Utek) set the roof sections for Building 'C'.  Framed the Club House walls.  Set the floor sections on Building 'D' & 'E'.

(Red Oak Plumbing) ran the water lines for the South side 3rd floor.  Set the ADA tubs.  And fire caulked the 4th floor.






Tuesday 11/27/2012

Weather: Sunny 48˚/21˚

Subs on Site
<Cardalls>                     (2)
<Warburtons>               (12)
<Diamond Z>                 (3)
<Extreme Fire>              (3)
<Air Doctors>                (4)
<Utek>                          (19)
<Red Oak Plumbing>     (2)

Work in Progress:
(Cardalls)Insulated all the ceilings on the 2nd Floor for Building 'A'.

(Warburtons) installed siding on the Southern end of Building 'A'.  Installed house wrap on the West and East side of the center section.  Roofed the East side.

(Diamond Z) installed the Stone on the North West corner of Building 'A'.

(Extreme Fire) worked on the attic system for Building 'A'


(Air Doctors) finished Installing the Hard ducts on Building 'A' 1st floor.

(Utek) Repaired the crane cable and started setting trusses on Building 'C'.  Continued pre fabing floor sections for Buildings 'D' and 'E'. Started the Club House.

(Red Oak Plumbing) finished and passed off the gas for the 3rd and 4th floors of Building 'A' and started on the water lines.  They also started drilling holes for the gas and drain on Building 'C'


Monday 11/26/2012

Weather: Sunny 45˚/20˚

Subs on Site
<Cardalls>                     (2)
<Warburtons>               (12)
<Diamond Z>                 (5)
<Air Doctors>                (4)
<Utek>                          (12)
<Red Oak Plumbing>     (2)

Work in Progress:
(Cardalls)Insulated all the walls on the 1st Floor for Building 'A'

(Warburtons)Shingled the lower entry roofs.  Started siding and worked on the North East corner of Building 'A' with the house wrap.

(Diamond Z)stoned the west side of Building 'A'.

(Air Doctors) installed their hard ducts.

(Utek) finished up the roof section for Building 'C'.  Pre fabbed the floor sections for Building 'D' & 'E'.

(Red Oak Plumbing) finished the gas on the 3rd and 4th floors of Building 'A'

Sub Meeting  11/26/2012
Jesse (Diamond Z)
William (Air Doctors)
Craig (Red Oak)
Doug (Cardalls)
Konrad (Nutek) via phone

Talking Points

  1. Dumpster is for Utek trash only.  I must police this and you will be back charged if you use it.
  2. Building Clean-up.  All sub must clean after themselves.  No cups, no trash in the Building.  Reliance cleaned up after all subs on the 2nd floor.  Thank you, Bryson.
  3. Air Doctors would like to have the drops framed before the run their ducts.  They will install their hard duct then we will frame the drops.
  4. Insulation will take 5 days per floor because their are only 2 guys.  We will move up and do the pre Rock on 2nd floor tomorrow.
  5. Drywallers will hang the whole 1st floor lid on Wednesday and start the garages while they wait for the insulators.
  6. Plumbers will have all gas done tonight and ½ of the 3rd floor water done for inspection tomorrow.  All water will be done Thursday for inspection.
  7. Gas will start on Building ‘C’ Friday 11/30
  8. Sheetrock needs to be delivered for Building ‘C’ by the end of next week in order to avoid a price increase.  They will stack the rock to allow better access than Building ‘A’ was.

Schedule


Pre-Rock

3rd Floor    Tuesday   11/27
4th Floor Thursday 11/29

Final 4-way
1st  Floor Thursday          11/29
2nd Floor     Wednesday      12/5
3rd Floor     Friday       12/7
4th Floor Wednesday 12/12




Wednesday 11/21/2012

Weather: Sunny 52˚/27˚

Subs on Site
<Cardalls>                     (2)
<Warburtons>               (3)
<Diamond Z>                 (7)
<Extreme Fire>              (5)
<Air Doctors>                (4)
<Reliance>                    (11)
<Utek>                          (22)
<Red Oak Plumbing>     (7)
<DG Concrete>             (2)

Work in Progress:
(Cardalls)Insulated all the ceilings on the 1st Floor for Building 'A'

(Warburtons) finished taping the joints of their house wrap and started up the West side.

(Diamond Z) work on the stone on the South End of Building 'A'

(Extreme Fire) Worked on the sidewalls for the South end of Building 'A' and the attic system.  They also installed the sprinklers for the first floor of Building 'C'.  While drilling for the attic system riser the drilled a TJI on each floor (See picture below)

(Air Doctors) started building the hard duct on the first floor of Building 'A'.

(Reliance) started wiring the 4th floor of Building 'A'.

(Utek) stood the walls on the 4th floor of Building 'C' and continued the pre-fab of the roof sections for Building 'C'.


Tuesday 11/20/2012

Weather: Sunny 50˚/25˚

Subs on Site
<Cardalls>                     (2)
<Nutek>                         (7)
<Warburtons>               (3)
<Diamond Z>                 (7)
<Extreme Fire>              (5)
<Air Doctors>                (4)
<Reliance>                    (11)
<Utek>                          (22)
<Red Oak Plumbing>     (7)
<DG Concrete>             (2)

Work in Progress:
(Cardalls)Insulated all the walls on the 1st Floor for Building 'A' and met with Corey Coleman (IECC) their process is approved as long as they foam the penetrations.  They will run out of Ceiling insulation tomorrow and will let me know as soon as they can get more up here.

(Nutek) Sheet rocked the pre-rock areas on 1st floor.

(Warburtons) wrapped house wrap around the Southern 1/3 of Building 'A'.  Aaron (Uintah County) would like them to tape all seams not just around the penetrations.

(Diamond Z) continued to put stone on the Southern end of Building 'A'.  Jesse noticed that the columns above the entry gables do not have flashing.  They well cut their gray coat up 6" so that Warburtons can install the flashing on Monday.

(Extreme Fire) worked on the 1st floor of Building 'C' as well as the sidewall sprinklers for the decks and closets on the 1st floor of Building 'A'.  They also started the attic section on Building 'A'

(Air Doctors) installed the exhaust vents on the 1st floor of Building 'C'

(Reliance) pulled wire on 3rd floor Building 'A'.

(DG Concrete) finished the rock walls for Building 'A' and started spreading road base for the sidewalks.







Monday 11/19/2012

Weather: Sunny 51˚/28˚

Subs on Site
<Cardalls>                     (2)
<Nutek>                         (5)
<Warburtons>               (4)
<Standard Builders>     (3)
<Diamond Z>                 (7)
<Air Doctors>                (4)
<Reliance>                    (11)
<Utek>                          (17)
<Red Oak Plumbing>     (7)
<DG Concrete>             (2)

Work in Progress:
(Cardalls) started insulating pre rock areas of the last 6 of 8 units on Building 'A' 1st floor

(Nutek) sheet rocked the pre-rock areas of the first 2 of 8 units on Building 'A' 1st floor

(Warburtons) Started shingling Building 'A'

(Standard Builders) installed the metal door frames in the under stair closets on Building 'A' and the patio closets on 1st floor of Building 'C'

(Diamond Z) started laying stone on Building 'A'

(Air Doctors) worked on the exhaust fans for the first floor of Building 'C'.

(Reliance) pulled wire on Building 'A' second floor and started boxing on 3rd floor.  They also added outlets for the units on 1st floor were the sliding doors were on the wrong side.

(Utek) finished standing the walls on Building 'C' 3rd floor and started setting sections of 4th floor.

(Red Oak Plumbing) finished the vents and worked on the water lines for the 2nd floor of Building 'A'

(DG Concrete) stacked the rock wall on the East side of center section of Building 'A'

Sub Meeting  11/19/2012
Pablo (Extreme Fire)
Jesse (Diamond Z)
William (Air Doctors)
Shad (DG Concrete)
Bryson (Reliance)
Jesse (Utek)

Talking Points

  1. Dumpster is for Utek trash only.  I must police this and you will be back charged if you use it.
  2. We will be striping the parking lot this week.  No parking around Building ‘A’.  Park off pavement.
  3. Building Clean-up.  All sub must clean after themselves.  No cups, no trash in the Building.  Reliance cleaned up after all subs on the 2nd floor.  Thank you, Bryson.
  4. We cannot finish the rock walls on Building ‘C’ without closing off access for lifts on the entire North side.
  5. We need to stub out for the sidewall heads in each patio before stone and siding.
  6. Air Doctors would like to have the drops framed before the run their ducts.  They will install their hard duct then we will frame the drops

Schedule
Pre-Rock
2nd Floor Tuesday  11/20
3rd Floor   Tuesday  11/27
4th Floor Thursday 11/29

Final 4-way
1st  Floor Tuesday  11/27
2nd Floor     Friday     11/30
3rd Floor    Thursday 12/6



Friday 11/16/2012

Weather: Sunny 49˚/24˚

Subs on Site
<Warburtons>               (4)
<Diamond Z>                 (5)
<Air Doctors>                (4)
<Reliance>                    (4)
<Utek>                          (22)
<Red Oak Plumbing>     (7)
<DG Concrete>             (2)

Work in Progress:
(Warburtons) Dried in all three garages

(Diamond Z)Started scratch coat on Building 'A'.  We did not have a hose addapter for the hydrant meter so I had to run and buy one.

(Air Doctors)touched up the fire caulking and worked on the vents in the attic.

(Reliance) Continued pulling wire on 2nd Floor.

(Utek) Set wall sections for Building 'C' 3rd Floor,  Started pre-fab on Building 'C' 4th floor. Continued pre-fab on Building 'B' wall sections

(Red Oak Plumbing) fire caulked the fire sprinkler pipes for the 1st and 2nd floors of Building 'A' and finished vents through the roof.




Thursday 11/15/2012


Weather: Sunny 44˚/24˚

Subs on Site
<Warburtons>               (4)
<Diamond Z>                 (5)
<Air Doctors>                (4)
<Reliance>                    (4)
<Utek>                          (22)
<Red Oak Plumbing>     (7)
<DG Concrete>             (2)

Work in Progress:
(Warburtons) dried in Building 'A"

(Diamond Z) Finished the lath and tar paper on the East side of Building 'A'.and passed inspection.

(Air Doctors) finished the vent pipes out of the chimney

(Reliance) Continued pulling wire on 2nd Floor.

(Utek) Sheeted the 3rd floor of Building 'C'. Stocked the wall sections for Building 'C' 3rd Floor,  Installed fire stop and draft stop in Building 'A' first floor demising wall floor section..

(Red Oak Plumbing) finished the gas lines on the 1st and 2nd floors on the South End of Building 'A' and Fire caulked for inspection..

(DG Concrete) Built rock wall on the West side of Building 'A'.
