<Reliance> (5)
<Red Oak Plumbing> (2)
Work in Progress
(Wall to Wall) Prepped 6 units on 2nd floor Building 'C'.
(SBS) Arrived at 5 pm after having fuel pump problems and stocked trim in the units on the West side of the 3rd and 4th floors of Building 'C'.
(Diamond Z) Started laying stone on Building 'D's South West corner.
(Nutek) Textured the 1st floor of Building 'D'. Hung drywall on the 2nd floor of Building 'D'.

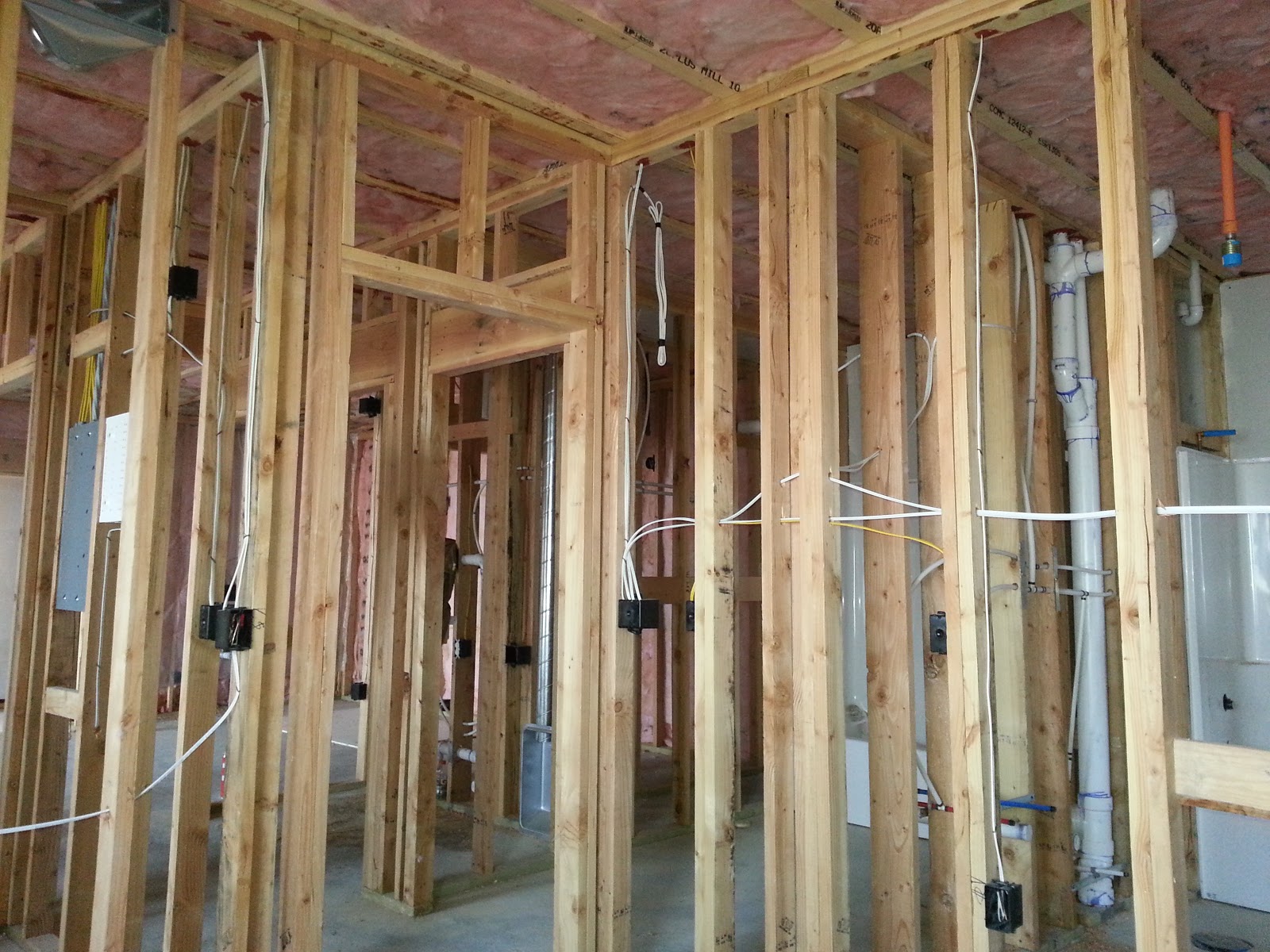

(Cardalls) Finished insulation on 3rd floor Building 'E' and worked on 4th floor.
(Warburtons) Worked on the North side of Building 'C' and the 4th floor West breeze way and 2nd floor of the East breezeway..
(Air Doctors) Installed flex ducts on the 3rd floor in Building 'D'. Installed trim on the 3rd floor South Tower of Building 'A'.
(Reliance) Worked on the last 4 units North tower trim. Wired the fans and lights in the drops on 3rd and 4th floor Building 'D'
(Red Oak) Installed water lines in Building 'B' and started trim on the South tower Building 'A'




Sub Meeting 2/25/2013
Rick (Warburtons)
Bryson (Reliance)
William (Air Doctors)
Ether (Red Oak)
Rob (Wall to Wall)
Sean (Extreme Fire)
Talking Points:
Track out and Mud: Each contractor is responsible for their own track out both into the street and onto our lot. I will look into getting some gravel for a track out.
Heaters: I asked that only the foremans, who know of the fire sprinkler problem, can touch the heaters we have already had heaters in Building ‘C’ turned too high.
Building ‘A’ Red Oak has not started his trim in Building ‘A’. Air Doctors still needs to trim 3rd and 4th floors on the South Tower. Reliance has the South Tower units complete in Building ‘A’ they should have the last 4 units on the North Tower today. Reliance will need a couple days next week to install the light poles and corridor lights and signs. Bryson is concerned that the conduits may have ice in them. Unit 405’s main breaker is tripped, Bryson will attempt to locate the area were the main feeder got hit and determine if it is a trim nail or siding. The block-outs for the lights in corridors are correct but the exit sign blocks need to be fixed. Rick (Warburtons) told Bryson (Reliance) to let Jose (Warburtons) know again and they would get them fixed. Carpet will be installed tomorrow 2/26 on the 1st floor and then as close as they can chase the plumbing trim on 2nd. When the carpet is installed he can touch up Building ‘A’ on Friday. The kickers are still on the roof and in the chimneys on Building ‘A’ Rick (Warburtons) said they will get them down this week. Sean (Extreme Fire) needs to get water in the sprinkler system for Building ‘A’. The sooner the better, if there is any leaks at all will make a big problem bigger if the carpet is installed.
Building ‘C’ Vinyl will be installed on 1st floor tomorrow 2/26. Ryan (SBS) had car problems and did not make it up here this morning he will have 3rd floor on the West tower ready for paint by the end of the day on 2/26.. Rob (Wall to Wall) said they will finish paint on all 2nd floor and the 3rd floor West tower this week and finish the building next week. (G&M Woods) will start cabinet install on Wednesday 2/27.
Building ‘D’ 1st floor was textured today. 2nd floor should be textured by 3/5. Gypcrete will be poured on Thursday 2/28. William (Air Doctors) Said that they will have the 3rd floor complete for Nutek in the morning. The Corridors will be formed this week and if possible poured Friday 3/1. Siding will start in 2 weeks.
Building ‘E’ Insulation will be complete by the end of the day Tuesday 2/26. Sheetrock will be stocked today and tomorrow.
Building ‘B’ Ether (Red Oak) will be ready for DWV on Tuesday 2/26. Bryson (Reliance) said that they need a week to finish the back of house install and then they will be able to wire 4 units per day from there on out.
Schedule:
Building ‘A’
Carpet 1st floor 2/26
Final inspection 3/5
Building ‘C’
2nd floor Paint started 2/25
1st floor Vinyl 2/25
2nd floor finish work complete 2/19
West side 3rd floor Texture complete by 10 am 2/20
East side 4th floor Texture complete end of day 2/20
Building ‘D’
1st floor drywall taped 2/26
2nd floor Drywall hung.
3rd floor ducts and fans complete 2/26
3rd floor drywall hung 2/27.
4th floor ducts complete 2/27
4th floor drywall hung 3/1
Building ‘E’
Insulation complete 2/26
Pre Rock on 1st floor starts Wednesday 2/27
