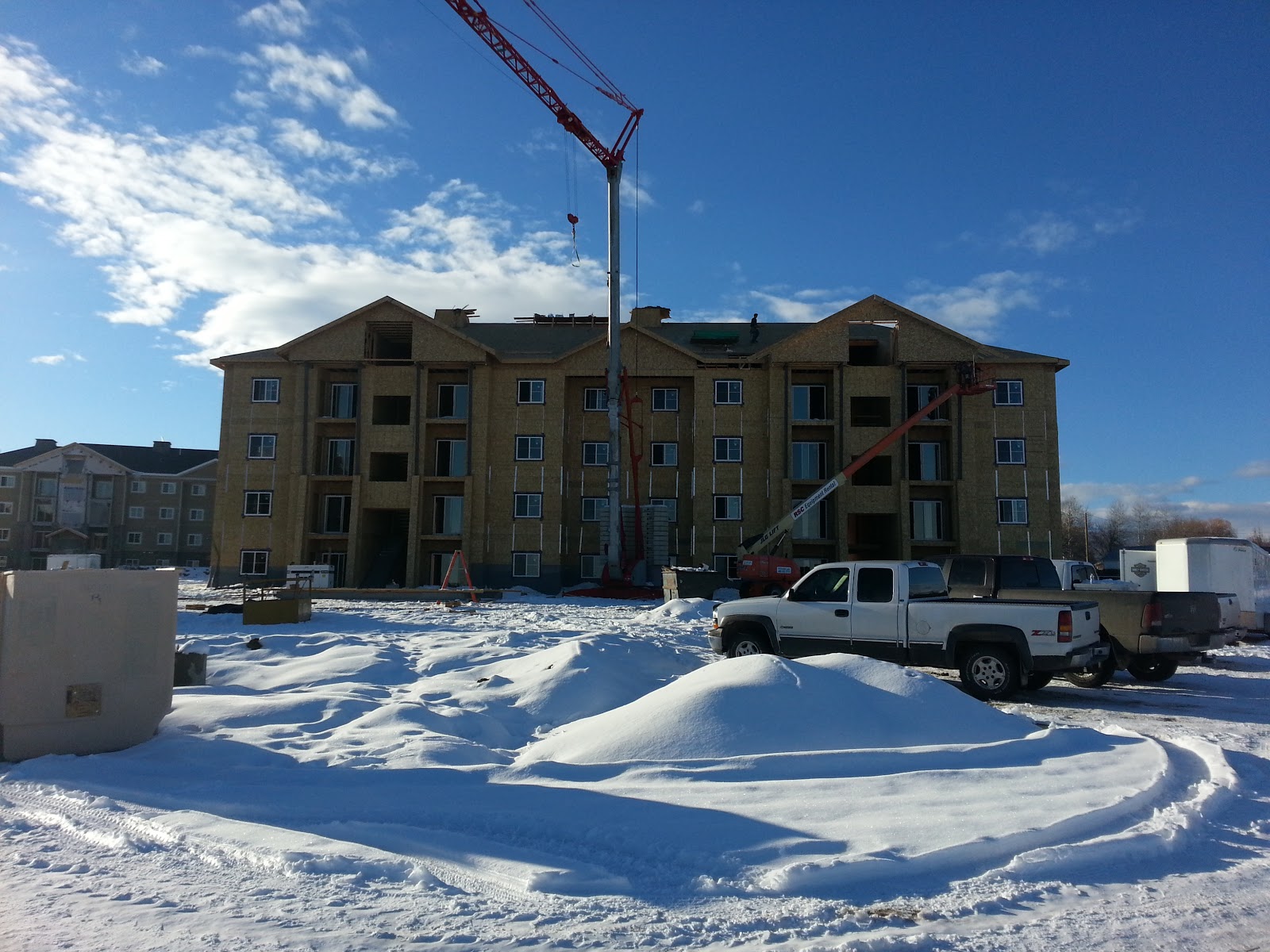

Thursday 1/31/2013


Weather: Partly Cloudy  31˚/7˚

Subs on Site
<G & M>                           (5)
<Wall to Wall>                  (4)
<SBS>                              (1)
<Nutek>                            (10)
<Cardalls>                        (4)
<Warburtons>                  (8)
<Air Doctors>                   (4)
<Clegg Steel>                  (6)
<Utek>                             (12)
<Reliance>                       (4)
<Red Oak Plumbing>       (6)

Work in Progress:
(G & M) Installed cabinets on the North end of 2nd and 3rd floor in Building 'A'.

(Wall to Wall) Painted 8 units on the 4th floor of Building 'A'.

(SDS) Hung the Breeze way doors on the East side 3rd and 4th in Building 'C'

(Nutek)Fire taped pre-rock on the East end of 3rd and 4th floor in Building 'C'  Taped behind the tubs on Building 'E'.  Finished hanging the sheetrock on 1st floor of Building 'C' and started taping it. LKL delivered the sheetrock for Building 'D' and stacked it for speedy stocking in the Building tomorrow. .

(Cardalls) Fixed areas from the insulation inspection on Building 'C'.  Started insulation on Building 'D' 1st floor.

(Warburtons) Worked on the West Breezeway 2nd floor of Building 'C'. Installed siding on the South center and West sections of  Building 'C'

(Air Doctors) Worked on the ducts on the 2nd floor in Building 'C'. Installed flue pipes in Building 'B'.

(Clegg Steel) Installed stairs on Building 'C' and delivered the beams for Building 'B'


(Utek) Finished setting Windows and doors on Building 'B' and Worked on the gable over builds.

(Reliance) Wired units on 4th floor of Building 'D' and passed inspection.


(Red Oak) Worked on gas on 3rd and 4th floors for Building 'E'. Passed inspection on 3rd and 4th floors of Building 'D'.  They still do not have the flex lines to hook up the furnaces on Building 'A'.


Wednesday 1/30/2013


Weather: Partly Cloudy  25˚/6˚

Subs on Site
<G & M>                           (5)
<Wall to Wall>                  (4)
<SBS>                              (1)
<Nutek>                            (10)
<Cardalls>                        (4)
<Warburtons>                  (8)
<Air Doctors>                   (4)
<Utek>                             (12)
<Reliance>                       (4)
<Red Oak Plumbing>       (6)

Work in Progress:
(G & M) Installed cabinets on the North end of 2nd and 3rd floor in Building 'A'.

(Wall to Wall) Primed 4 units on the South end of the 4th floor of Building 'A'.

(SDS) Hung the Breeze way doors on 3rd and 4th in Building 'C'

(Nutek) Finished hanging pre-rock on the East end of 3rd and 4th floor in Building 'C'  Fire taped 3rd floor Building 'C'.   Taped behind the tubs on Building 'E'.  LKL delivered the sheetrock for Building 'D' and stacked it for speedy stocking in the Building tomorrow.  They brought out a regular shop forklift which got stuck.  They borrowed our lift and said they would top off the gas when they are finished.

(Cardalls) Installed insulation on the East units on 4th floor of Building 'C'.  Started insulation on Building 'D' 1st floor.

(Warburtons) Worked on the South East gable of Building 'A'. Installed siding on the South center section of  Building 'C'

(Air Doctors) Worked on the ducts on the 2nd floor in Building 'C' then started on the West end of 3rd floor. Installed flue pipes in Building 'B'.

(Utek) Set Windows and doors on Building 'B' and Worked on the gable over builds.

(Reliance) Wired units on 4th floor of Building 'D'

(Red Oak)Worked on gas for Building 'E'. The filled the DWV in Building 'D'.  Rob (Red Oak) did not turn the fire hydrant all of the way on and water came up from the ground and down the road.  They passed Building 'D' re-inspections.





We had a robbery last night.  I got a call from the Sheriff this morning.  Apparently, I guy named Powell and a female came here looking for a door for a buddy.  We do not have any on site that are not hung so they stole some cordless tools and while trying to leave they got high centered on a curb between the garages.  The Sheriff impounded their vehicle and could not find Powell.  They brought in a K9 and found him in Building 'B' or 'E' (The Sheriff just knew it had no heat).  Powell confessed and the tools are in his vehicle in the impound lot.  The Sheriff said it might take unit tomorrow to get the warrant to get tools out of the vehicle.

Air Doctors did get their tools back, estimated $1000 worth.  Unit 201 in Building 'C' had the insulation pulled out of the walls and the plastic was shredded.  They might have found him in that unit.  I went to the Sheriff Station and asked for the report for our records.  Because they caught the guy it is now a prosecution and we will have to wait at least a week before we can get the report from the County Attorney.


Tuesday 1/29/2013


Weather: Snow 25˚/-4˚

Subs on Site
<Wall to Wall>                  (4)
<SBS>                              (1)
<Nutek>                            (10)
<Cardalls>                        (4)
<Warburtons>                  (8)
<Air Doctors>                   (4)
<Utek>                             (12)
<Reliance>                       (4)
<Red Oak Plumbing>       (6)

Work in Progress:
(Wall to Wall) Primed 4 units on the North end of the 4th floor of Building 'A'.

(SDS) Came back to install trim on the attic accesses in Building 'A' as well as fix some trim that was cut too short.

(Nutek)n Finished hanging pre-rock on the West end of 3rd floor in Building 'C' Started the 4th floor. Fire taped the last 4 units on 2nd floor Building 'C'. Hung the lids in Building 'B' chases.  Taped behind the tubs on Building 'E'

(Cardalls) Installed insulation on the West units on 4th floor of Building 'C'.and started on the East side on 3rd floor.

(Warburtons) Worked on the South East gable of Building 'A'. Installed siding on the South East corner of  Building 'C'

(Air Doctors) Worked on the ducts on the 2nd floor in Building 'C'. Installed flue pipes in Building 'B'

(Utek) Set Windows and doors on Building 'B' and cleaned off the snow of the roof so they could work on the over builds from the gables...

(Reliance) Wired units on 3rd floor of Building 'D'

(Red Oak) Started drilling out Building 'E' and running gas lines. Water Heaters were delivered and they stocked Building 'A' with them. Failed 4-way but took the list and finished it up for tomorrows inspection.





Monday 1/28/2013


Weather: Partly Cloudy / Hazy  42˚/-3˚

Subs on Site
<Wholesale Flooring>      (4)
<Wall to Wall>                  (4)
<Nutek>                            (10)
<Cardalls>                        (4)
<Warburtons>                  (4)
<Air Doctors>                   (4)
<Utek>                             (12)
<Reliance>                       (4)
<Red Oak Plumbing>       (2)

Work in Progress:
(Wholesale Flooring) Installed Vinyl in 8 units on the North End of Building 'A' 4 on 2nd and 4 on 3rd.

(Wall to Wall) Prepped 4 units on the North end of the 4th floor of Building 'A'.

(Nutek)n Finished hanging pre-rock on the 2nd floor of Building 'C'. Started pre-rock on the West end of 3rd floor in Building 'C' Fire taped 4 of 8 units on 2nd floor Building 'C'

(Cardalls) Installed insulation on the West units on 3rd floor of Building 'C'.

(Warburtons) Worked on some details on the inside of Building 'A' 4th floor breeze way Installed the house wrap on the South East corner of  Building 'C'

(Air Doctors) Worked on the ducts on the first floor in Building 'C'

(Utek) Set the steel columns on the entry ways for Building 'B' and craned the gables on to them..

(Reliance) Wired units on 3rd floor of Building 'D'

(Red Oak) I had to call their laborer to come and finish the fire caulk for Building 'C'.  They did not have fire caulk on site so we borrowed some from Air doctors.   Worked on Fire Caulk on the 1st floor of Building 'C'








Sub Meeting 1/28/2012

Rick (Warburtons)
Doug (Cardalls)
Eric (Nutek)
Konrad (Nutek)
Bryson (Reliance)
William (Air Doctors)
Rob (Wall to Wall)

Talking Points:
Ether (Red Oak) has completed Building ‘D’ four days ahead of schedule. This will cause more overlap on duct work.  On 2/6 until Building ‘C’ duct work is complete.  William (Air Doctors) said this will not be a problem.
Air Doctors and Utek have worked out a system to install the ducts and frame the drops on one floor in 4 days.
Nutek will hang drywall in the chase lids in Building ‘B’ so that Air Doctors can install the flue pipes while they have the man power.
Hardware will be delivered on 1/29
Electrical trim will start on 1/29
Water heaters will be delivered on 1/30
Appliances will be delivered on 2/6
Diamond Z would like to scratch coat both ‘D’ & ‘E” on Monday 2/4.  We need the the penetrations done on Building ‘E

Schedule:

Building ‘A’
Electrical trim starts 1/29
Water heaters delivered 1/30

4th Floor Painted Friday 2/1

Building ‘C’
1st floor Drywall on hanging starts 1/30
1st floor Drywall taping starts 2/4
1st floor Finish work starts 2/8


2nd floor Insulation starts 1/22
2nd floor Pre-Rock starts 1/24
2nd floor Drops Framed starts 1/28
2nd floor Ducts start 1/29
2nd floor ½” Drywall hanging starts 2/4
3rd & 4th floor West tower Pre-Rock Drywall starts 1/28
3rd & 4th floor West tower Framing and duct work starts 1/31


Building ‘D’
4-Way inspection 1st and 2nd Tuesday 1/29
DWV inspection Wednesday 1/30
Insulation 1st floor starts 1/31
4-way inspection 3rd and 4th Friday 2/1


Drywall Stocked 1/31
1st Floor Pre-Rock starts 2/4

Building ‘E’
4-way inspection 1st and 2nd floor 2/11



Friday 1/25/2013


Weather: Partly Cloudy / Hazy  29˚/8˚

Subs on Site
<Wall to Wall>                  (4)
<Nutek>                            (3)
<Cardalls>                        (6)
<Warburtons>                  (7)
<Diamond Z>                   (4)
<Clegg Steel>                  (8)
<Air Doctors>                   (5)
<Utek>                             (12)
<Reliance>                       (2)
<Red Oak Plumbing>       (2)

Work in Progress:
(Wall to Wall) Cleaned and stripped 4 units on the North end of 3rd floor of Building 'A'.

(Nutek) Hung pre-rock on Building 'C' 2nd floor units.

(Cardalls) Installed insulation on the West units on 3rd floor of Building 'C'.

(Warburtons) Worked on the South West gable of Building 'A' and started on Building 'C'

(Diamond Z) Finished all they could on Building 'C' until the roofers finish the flashing.

(Clegg Steel) Poured the stairs on Building 'A'

(Air Doctors) Worked on the ducts on the first floor in Building 'C'

(Utek) Started sheeting the roof on Building 'B' and built the hip on the North end.

(Reliance) Wired units on 3rd floor of Building 'D'

(Red Oak) Worked on Fire Caulk for Building 'D'








Thursday 1/24/2013


Weather: Partly Cloudy / Hazy  22˚/7˚

Subs on Site
<Wall to Wall>                  (4)
<SBS>                              (4)
<Nutek>                            (3)
<Cardalls>                        (6)
<Warburtons>                  (9)
<Diamond Z>                   (4)
<Extreme Fire>                (4)
<Air Doctors>                   (5)
<Utek>                             (12)
<Reliance>                       (4)
<Red Oak Plumbing>       (8)

Work in Progress:
(Wall to Wall) Painted 4 units on the North end of 3rd floor of Building 'A'.

(SBS) Laid base board on the Southern 4 units of the 4th floor of Building 'A'

(Nutek) Hung the drywall behind the tubs and chases on Building 'E'. Started Pre-rock on the 2nd floor Building 'C'

(Cardalls) Insulated the rest of  2nd floor Building 'C'. Started the West end of 3rd floor Building 'C'

(Warburtons) Worked on the South West gable of Building 'A'. They finished working on the area behind the 1/2 stair section so that Clegg Steel can pour the stairs on Friday.  Started drying in Building 'E'. They continue to have trouble with starting their man basket in the mornings.

(Diamond Z)Laid stone on the North East gable of Building 'C'

(Extreme Fire)Worked on the Attic system for Building 'D' and the plastic for Building 'B' and installed trim on 1st and 2nd floor of Building 'A'

(Air Doctors) Rough in on Buildings 'D' & 'E'.  Finished installing the Hard ducts on the 1st floor of Building 'C'

(Utek) Assembled truss sections for Building 'B' and set the rest of the main sections

(Reliance) Pulled wire in Building 'D' units

(Red Oak Plumbing) Finished water lines on Building 'D'.  Started Fire caulk.  Moved materials to Building 'E'.

Clegg Steel called me earlier in the week to ask if they could pour the stair pans on Saturday 1/26.  They called today and told me that they had to pour on Friday 1/25.  The finish carpenters will finish tonight and I moved the floor layers from Friday to Monday because they would not have access.






Wednesday 1/23/2013


Weather: Partly Cloudy  13˚/-2˚

Subs on Site
<Wall to Wall>                  (4)
<Nutek>                            (6)
<Cardalls>                        (5)
<Warburtons>                  (9)
<Diamond Z>                   (4)
<Extreme Fire>                (4)
<Air Doctors>                   (5)
<Utek>                             (12)
<Reliance>                       (4)
<Red Oak Plumbing>       (8)

Work in Progress:
(Wall to Wall) Primed 4 units on the North end of 3rd floor of Building 'A'.

(Nutek) Fire taped the  Pre-rock the 1st floor on Building 'C' and hung the areas around the fire sprinklers in the main rooms.

(Cardalls) Insulated 5 of the 8 units on 2nd floor Building 'C'

(Warburtons) Worked on the South West gable and finished the decks on the South East gable of Building 'A'. They started working on the area behind the 1/2 stair section so that Clegg Steel can pour the stairs on Saturday.

(Diamond Z)Laid stone on the North West gable of Building 'C'

(Extreme Fire)Worked on the Attic system for Building 'D' and the plastic for Building 'B'

(Air Doctors) Rough in on Buildings 'D' & 'E'.  Started installing the Hard ducts on the 1st floor of Building 'C'

(Utek) Assembled truss sections for Building 'B' and set the center sections

(Reliance) Pulled wire in Building 'D' units

(Red Oak Plumbing) Worked on  Water lines on Building 'D'.  Moved materials to Building 'E'.




Tuesday 1/22/2013


Weather: Clear  16˚/-9˚

Subs on Site
<Wall to Wall>                  (4)
<Nutek>                            (6)
<Cardalls>                        (5)
<Warburtons>                  (9)
<Diamond Z>                   (4)
<Extreme Fire>                (4)
<Air Doctors>                   (5)
<Utek>                             (12)
<Reliance>                       (6)
<Red Oak Plumbing>       (8)

Work in Progress:
(Wall to Wall) Painted 4 units on the North end of 2nd floor of Building 'A'

(Nutek) Pre-rocked the 1st floor on Building 'C' they did not hang all of the 5/8" as was planned they only hung the drop areas.

(Cardalls) Insulated the exterior walls on 1st floor of Building 'C' and started on 2nd floor

(Warburtons) Worked on the North West gable and the decks on the South East gable of Building 'A'.

(Diamond Z)Laid stone on the North West gable of Building 'C'

(Extreme Fire)Worked on the Attic system for Building 'D' and the plastic for Building 'B'

(Air Doctors) Rough in on Buildings 'D' & 'E'

(Utek) Started assembling truss sections for Building 'B'

(Reliance) Pulled wire in Building 'D' units

(Red Oak Plumbing) Stocked tubs in Building 'B' and Finished DWV on Building 'D'
